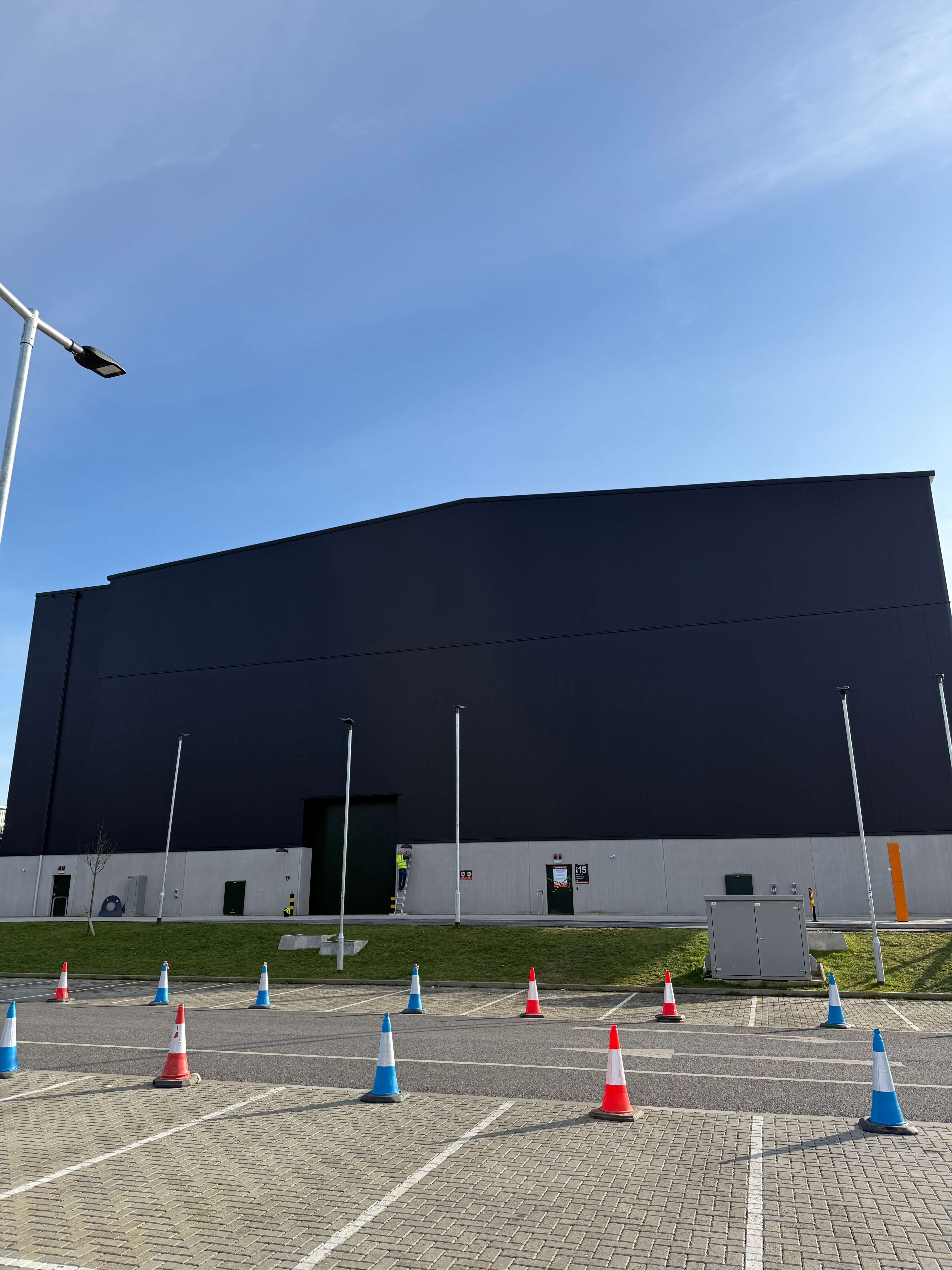

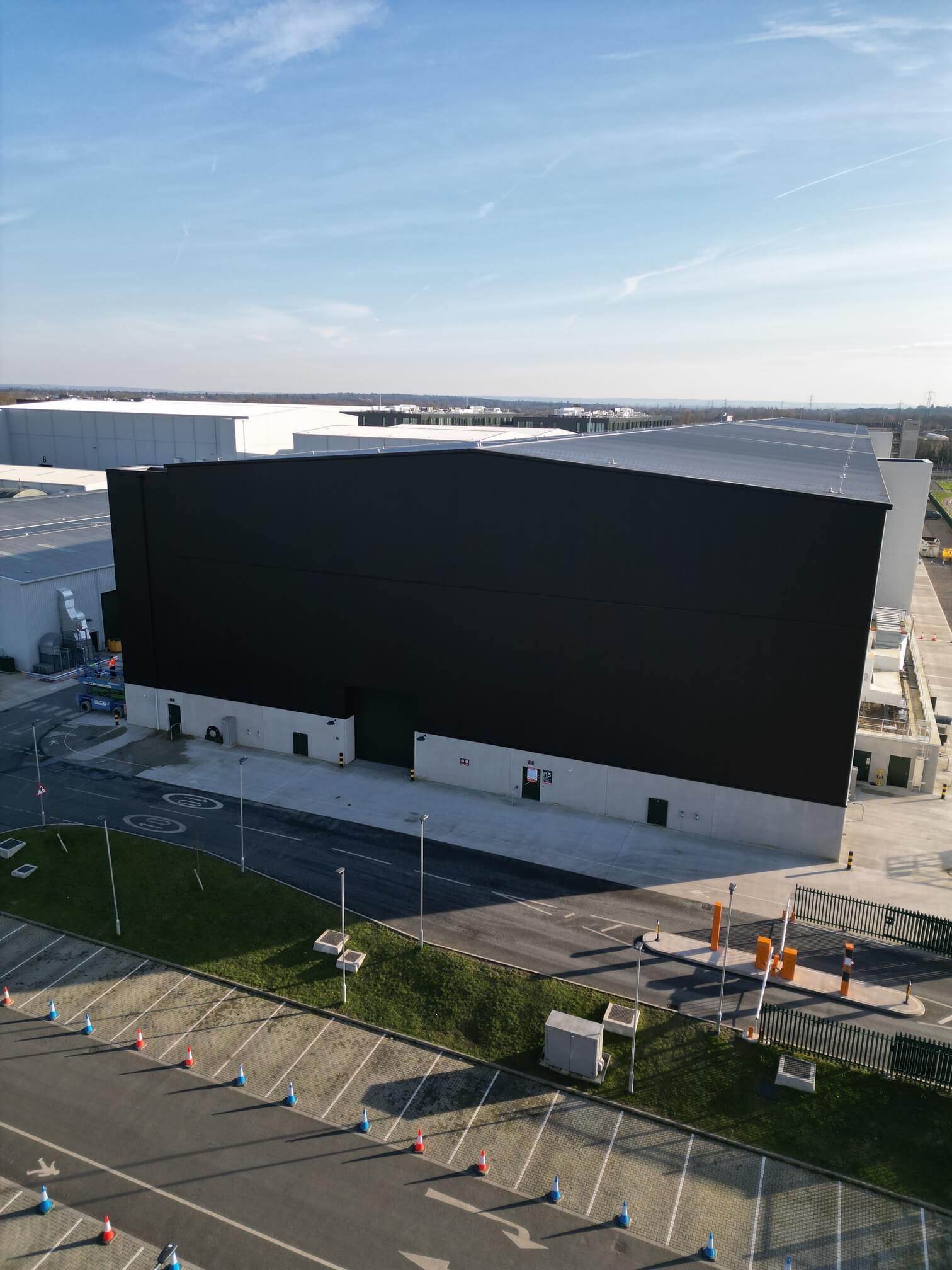

Preparing a studio elevation for new signage
The work covered approximately 780 m² of cladding on a studio elevation, preparing it for new signage. The project involved thorough cleaning and controlled airless spray painting to create a consistent finish. Scissor lifts and boom lifts provided access, with preparation and spraying coordinated around studio operations.

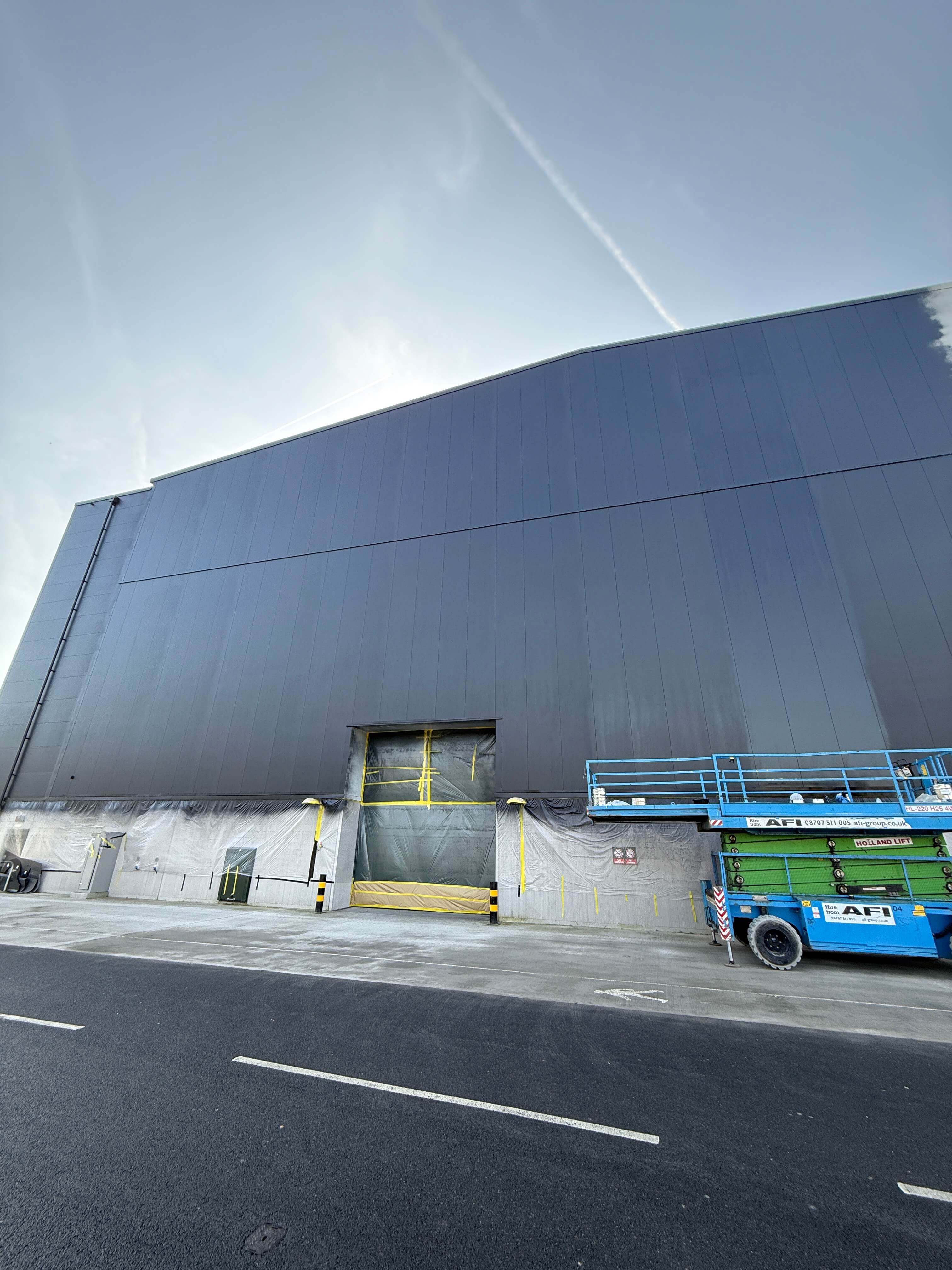

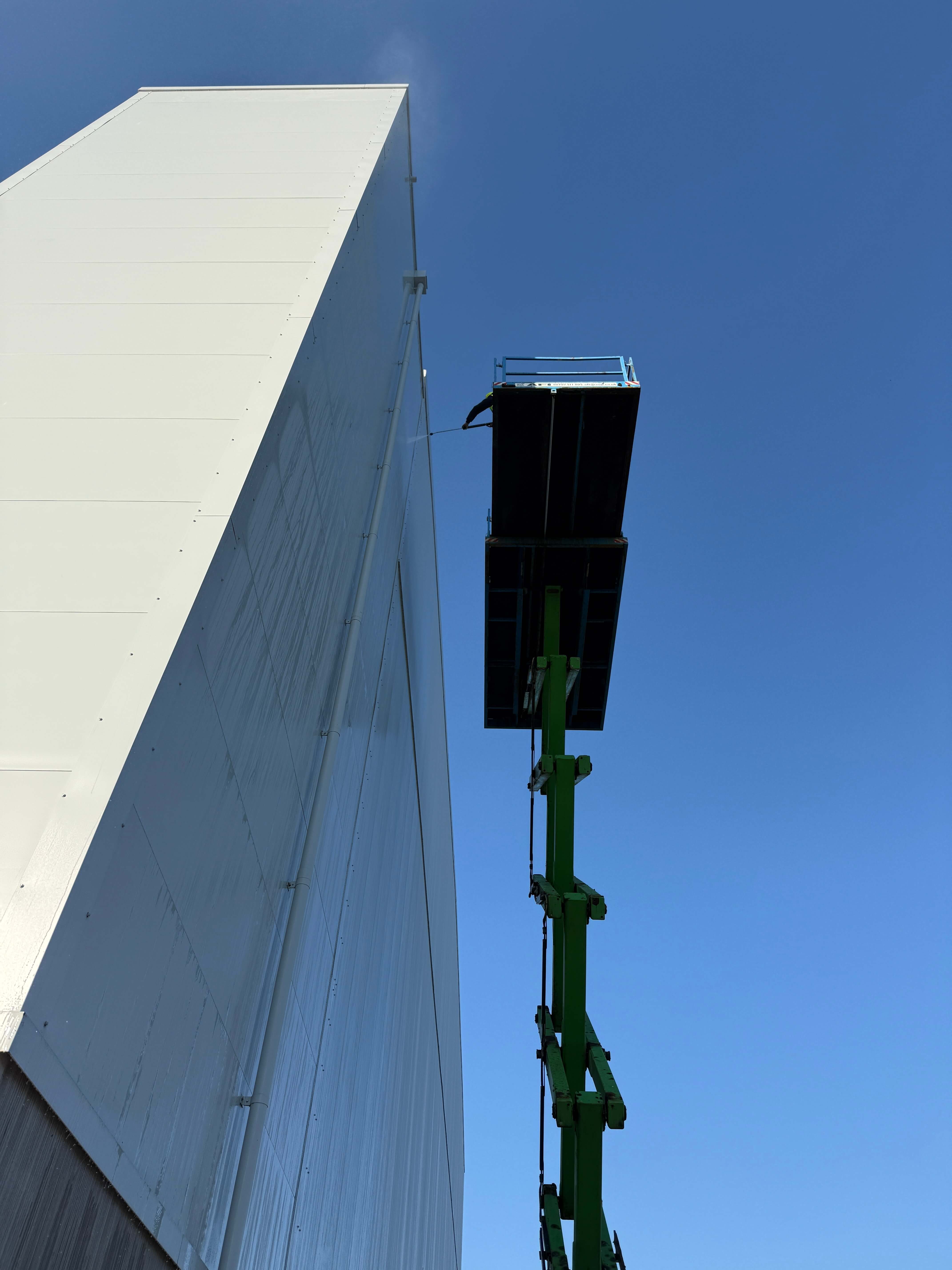

Shepperton Studios; Large-Scale Cladding Spray Painting Project
Shepperton Studios
3 Days
780m²
2025
Project Challenges & Solutions
Height & Access Challenges
- Scissor lifts and boom lifts provided access to the elevated cladding areas.
- Operatives were required to hold appropriate IPAF training for the powered access equipment used.
- Solution: Access planning, trained operatives and site controls supported the work at height.

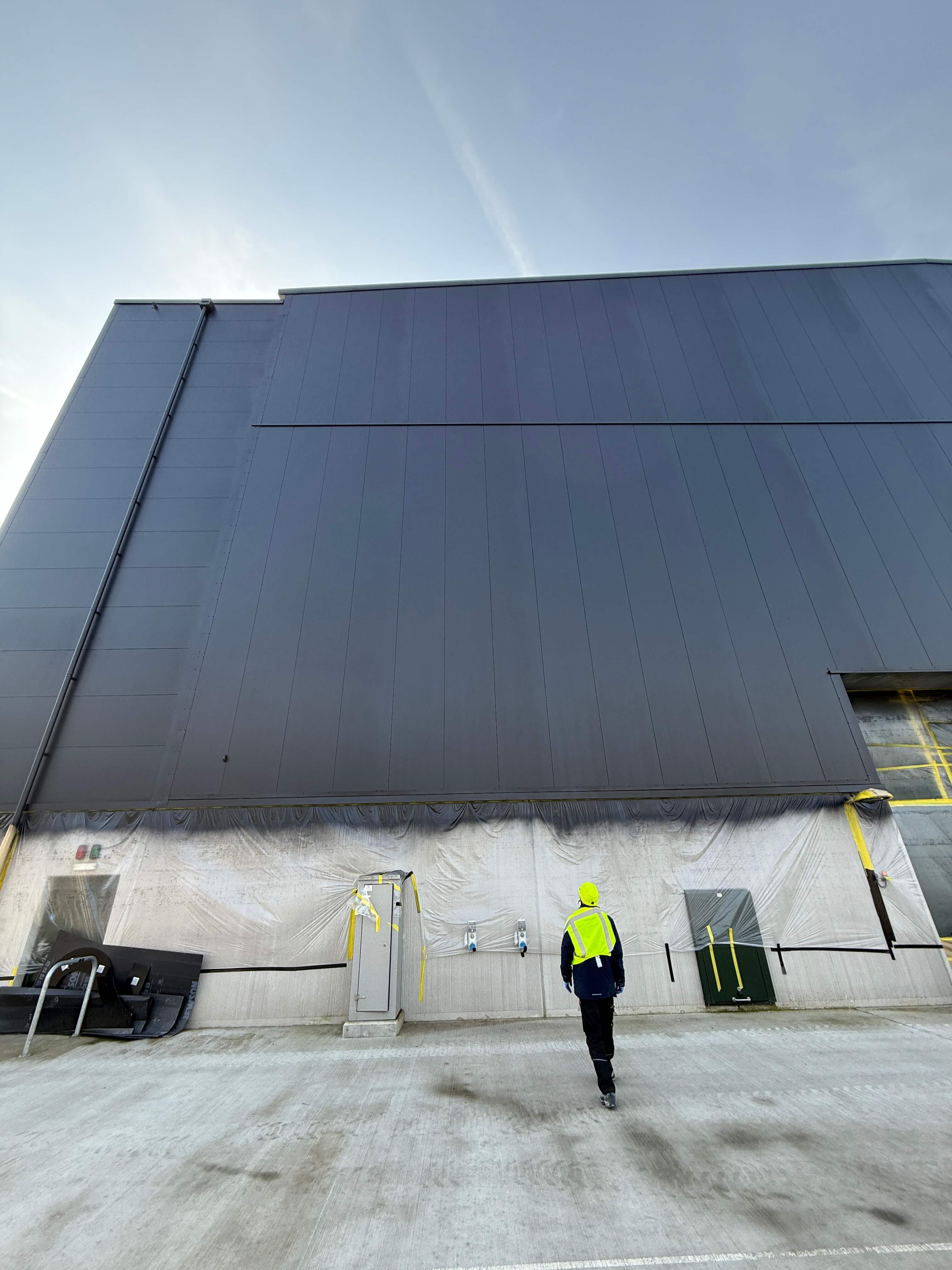

Surface Preparation & Cleaning
- The cladding required a deep clean to remove dirt, grime, and residues before painting.
- Any contaminants left on the surface would affect paint adhesion and longevity.
- Solution: A thorough power wash and degreasing were carried out to prepare the surface for priming and spraying.
Health & Safety Compliance
- Working at height posed risks requiring strict adherence to health & safety regulations.

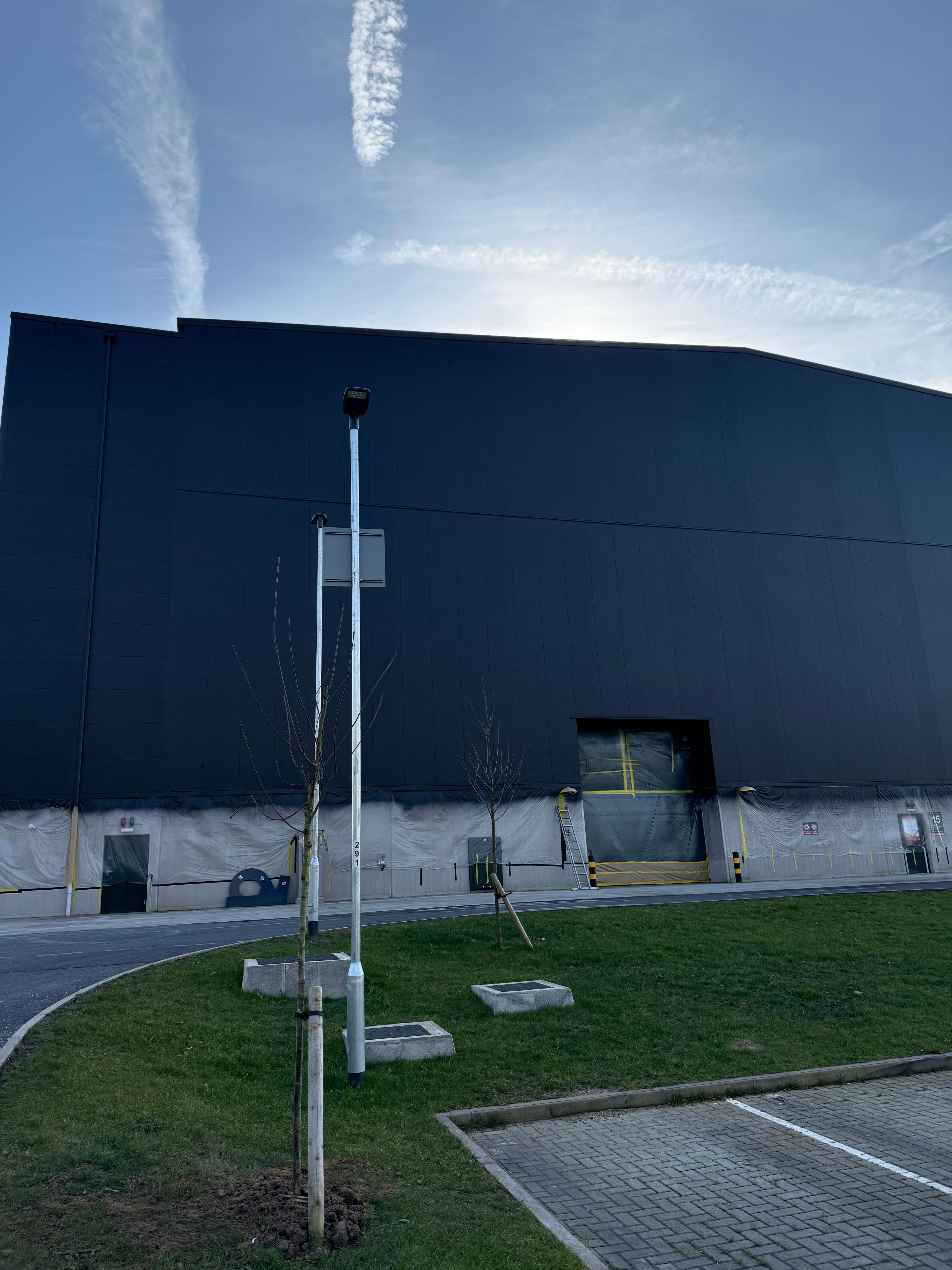

- The team worked to the project RAMS and agreed site controls, with IPAF-trained operators using the powered access equipment.
- Solution: Risk assessments, method statements (RAMS), and PPE requirements were fully enforced on-site.
Achieving a Durable & Even Finish
- The aim was a consistent finish across the cladding, ready for the new signage.
- Solution: We used airless spray painting equipment to apply the coating evenly across the prepared surfaces.
The Process
Step 1: Site Preparation & Safety Measures
- Full risk assessment and method statement (RAMS) implementation.

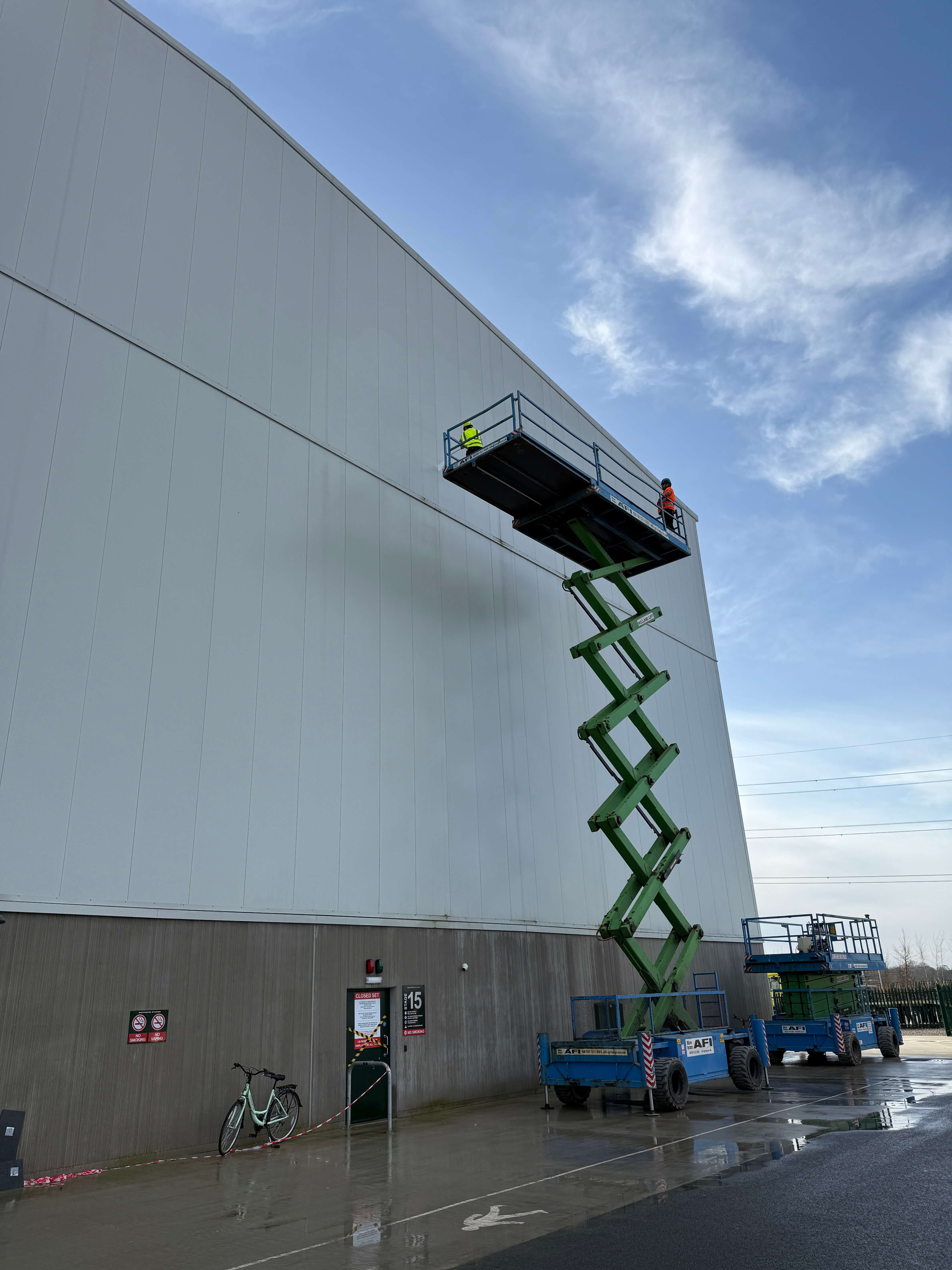

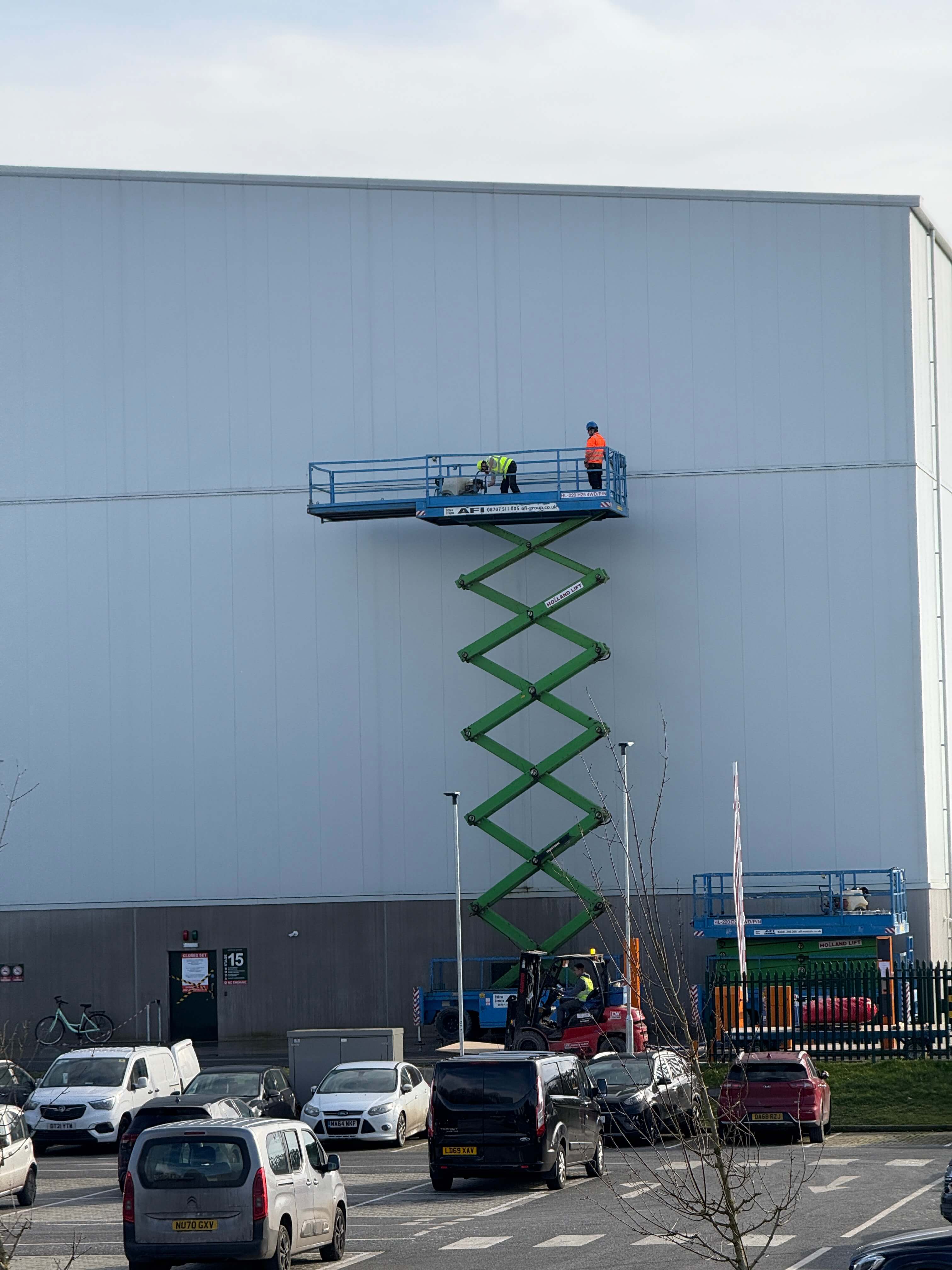

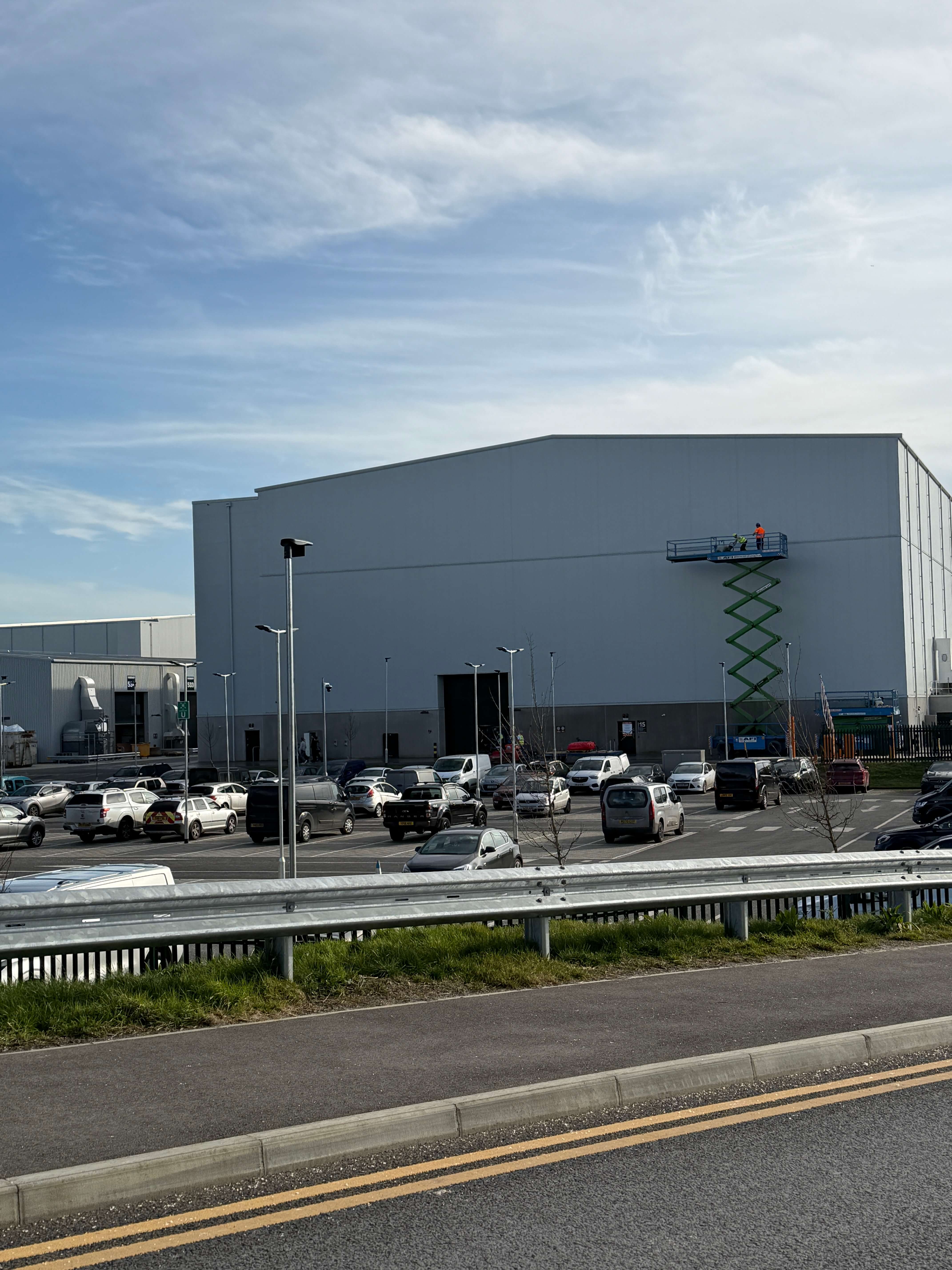

- Scissor lifts and boom lifts were positioned to ensure safe and efficient access.
- Team briefing and coordination to ensure minimal disruption to studio operations.
Step 2: Cleaning & Surface Preparation
- High-pressure washing of the cladding to remove debris and contamination.
- Surface dried and inspected before painting to ensure proper adhesion.

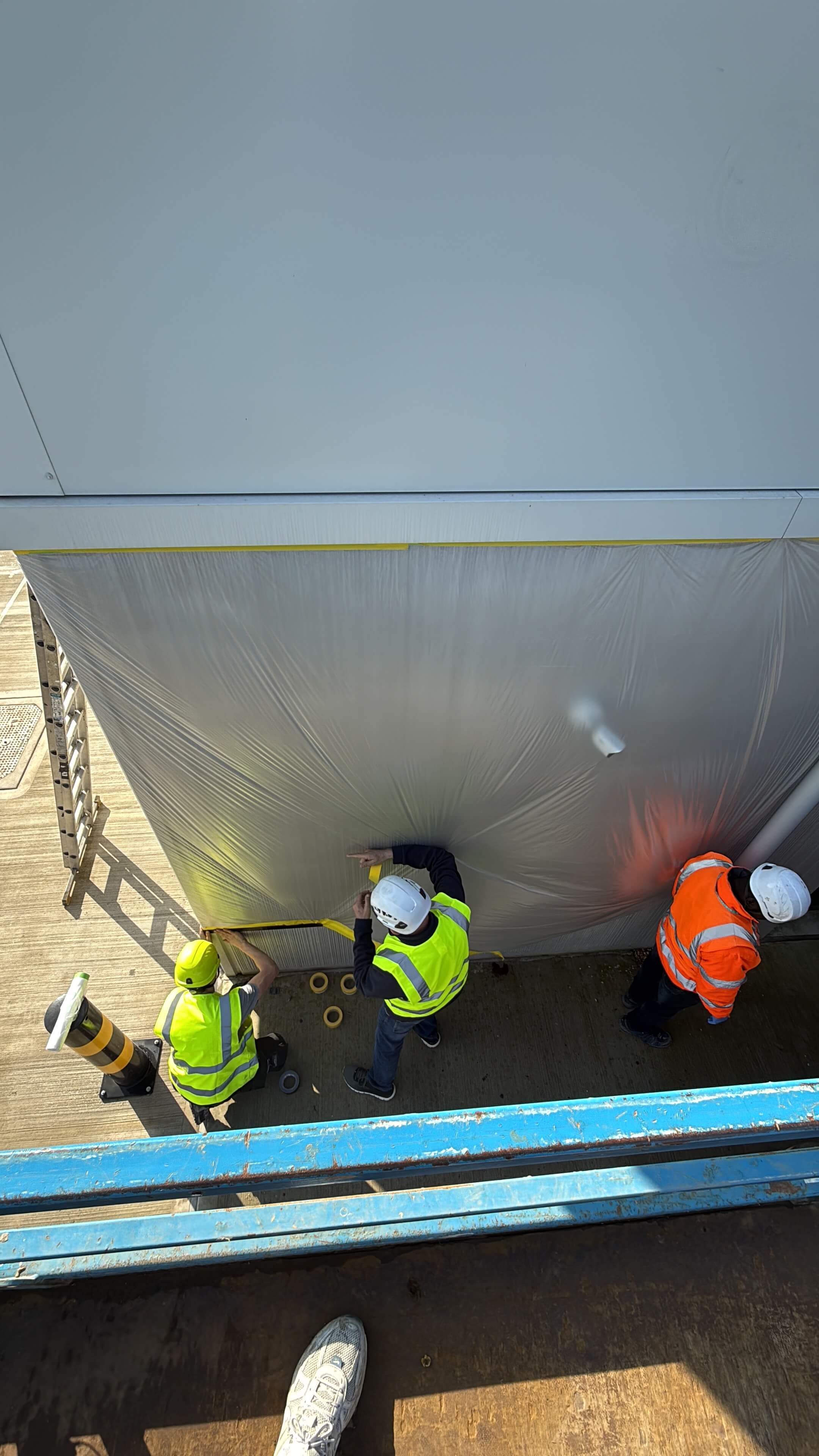

Step 3: Airless Spray Painting Application

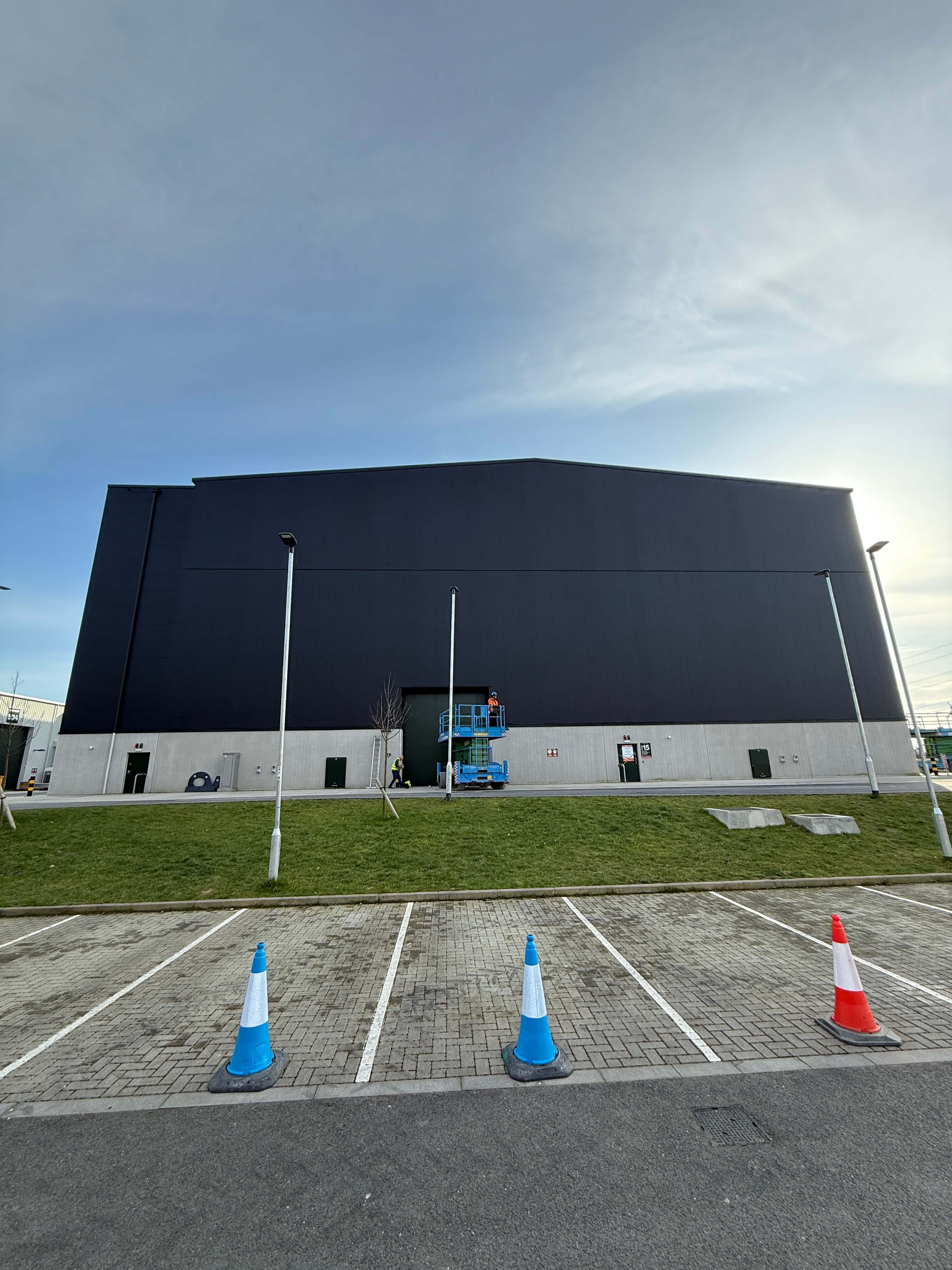

- The specified industrial coatings were applied using airless spray equipment for a consistent finish.
- Multiple passes were used to achieve even coverage.
Step 4: Quality Check & Final Inspection
- Once dry, the surface was thoroughly inspected to check consistency and coverage.
- The project was signed off as ready for signage installation.

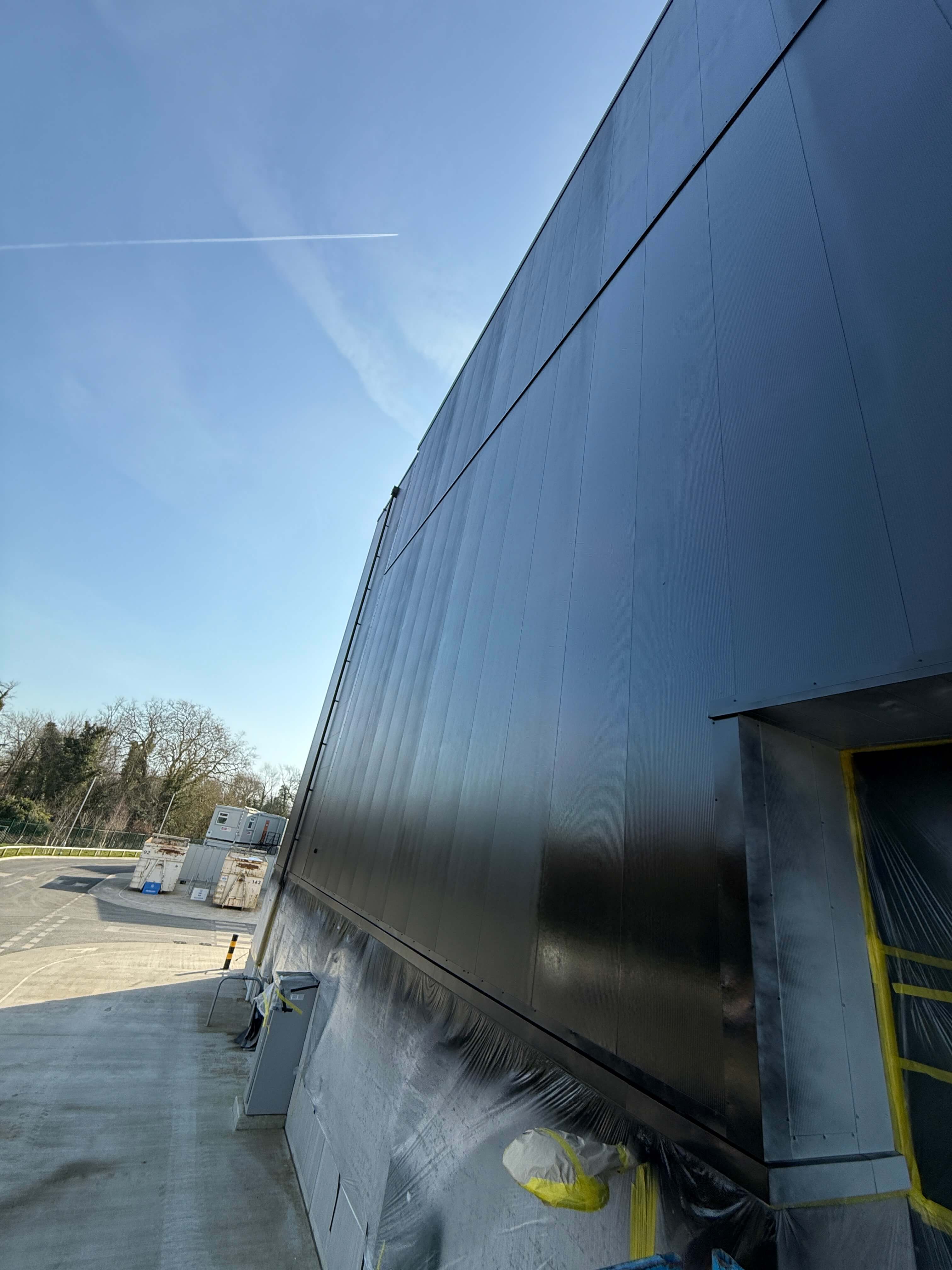

The Results
A consistent finish, ready for the new signage.
Planned access and site controls, coordinated around studio operations.
On-time and on-budget completion, with the elevation handed over ready for signage.
A renewed protective finish on the existing cladding.
Request a Tailored Quotation.

NuColour did a great job on the cladding at Shepperton Studios. The team were easy to work with, turned up when they said they would, and the finish was exactly what we were after. Would happily work with them again.
Bruce
Managing Director, Signs of Success
Cladding Refurbishment Around Studio Operations
Specialist access equipment and trained operatives helped us deliver the cladding coating work at height. Preparation, site controls and airless application were planned together to produce a consistent finish ready for the new signage, with the work coordinated around studio operations.

projects

Commercial Warehouse Cladding Refurbishment | Wembley, London

Burger King Enfield Roof Refurbishment
